Shipping methods of my custom paper packaging save shipping costs

Paper Bag Manufacturer Lead Time

Paper Bag Manufacturer Lead Time:
How Long from Artwork to Delivery?

If you are planning a product launch, a trade show, or a seasonal push, the single number that quietly decides whether your packaging arrives in time is paper bag manufacturer lead time. Most first-time buyers ask a factory “how long?” and get a confident-sounding “three weeks” that collapses the moment a proof needs a revision or a ship gets delayed. The honest answer is that lead time is not one number. It is the sum of artwork approval, sampling, production, quality checks, and transit, and each stage has its own clock. This guide walks through a realistic artwork to delivery timeline paper bags buyers can actually plan against, shows how quantity and shipping mode move the total, and gives you concrete ways to reduce paper bag lead time without paying a premium you did not budget for. Most suppliers organize their schedules around the sustainable-packaging framework in ISO 18601:2013, so the stage names below will sound familiar. For the full picture across materials and sizing, start with our complete guide to custom printed paper bags.

Branded paper bags 6 Top Popular Paper Bags ,moq-for-custom-printed-paper-bags
Designs & Samples
Paper Bag Manufacturer Lead Time
Mass production
QC inspection of custom packaging
Inspection
Shipping methods of my packaging from APP Customized Packaging Solutions Save shipping costs
Shipping

Key Takeaways

  • A typical custom order runs 4–10 weeks door-to-door, but the split is roughly 1–3 weeks of sampling and production prep and 2–6 weeks of ocean transit.
  • Paper bag sampling time / PPS lead time is the step buyers forget. Budget 5–10 business days for a pre-production sample, plus shipping both ways.
  • Order quantity is the biggest driver of how long to manufacture custom paper bags: 500 units and 20,000 units can differ by 1–3 weeks on the production floor alone.
  • Ocean freight is cheap but slow (25–40 days from Asia); air is fast (5–10 days) but can cost 5–10x more. Your shipping choice can outweigh the factory’s speed.

What “Lead Time” Actually Covers

When a supplier quotes a lead time, the term is doing a lot of work. Some factories mean “time from deposit to ex-factory date.” Others mean “time until it leaves our loading dock.” Almost none mean “time until it reaches your warehouse.” So before you plan, define the clock.

A complete paper bag production lead time has six stages. Miss any one in your own schedule and the whole project slips:

  1. Artwork submission and technical review — you send the file; the factory checks bleed, color mode, and die lines.
  2. Pre-production sample (PPS) — a physical proof of one or a few bags made on the real line.
  3. Sample revision and approval — you review, request changes, the factory re-makes.
  4. Bulk material preparation — paper, handles, ink, and dies are staged.
  5. Mass production and in-line QC — the run itself, with checks during the run.
  6. Finishing, packing, and transit — lamination or handles attached, cartons built, then ocean or air to your door.

The first five sit inside the factory. The sixth is logistics, and it is where most “three weeks” promises fall apart. We cover both halves below so you can build a timeline that survives contact with reality.

The Standard Production Timeline

StageWhat happensTypical duration
Artwork technical reviewFile checked for color, bleed, die lines1–3 business days
PPS productionOne sample bag made on the real line3–5 business days
PPS shipping + your reviewCourier both ways + decision time2–4 business days
Bulk material prepPaper, ink, handles, dies staged3–5 business days (can overlap PPS)
Mass productionThe actual run + in-line QC5–15 business days by quantity
Finishing & packingLamination, handles, cartons1–3 business days
Factory subtotalEx-factory, before transit~2–6 weeks

Here is the floor-to-floor view of a normal order that goes right the first time. These are planning ranges for a China-based offset or flexo run; your factory’s numbers will vary, so always confirm.

The table assumes no major artwork revision. Add a revision cycle and you add another 1–2 weeks, because the sample must be re-made and re-shipped. The biggest lever you personally control is how fast you approve that sample, which is why the next section exists.

Not sure how your print method affects speed? Our printing methods compared guide breaks down which processes add setup days and which skip them entirely.

How Order Quantity Changes Everything

Order quantitySampling (PPS)Mass productionFactory total
100–500 units (digital)3–5 days3–7 days1–2 weeks
500–3,000 units (offset)5–10 days7–12 days3–4 weeks
3,000–10,000 units5–10 days12–15 days4–5 weeks
10,000–50,000+ units7–10 days18–25+ days5–8 weeks

Production time is not linear. A press carries the same fixed setup whether you print 500 or 5,000 bags, but a larger run simply takes longer to physically push through the machine. The jump between tiers is what surprises buyers. Notice the sampling time barely moves, but production scales hard with volume. If you are still deciding how many to order, our custom printed paper bags MOQ guide shows the quantity thresholds where per-unit price and lead time both shift. A common trap is ordering right below a tier boundary: you pay nearly the same setup as the next tier but wait almost as long for fewer bags.

Sampling and the PPS Step Buyers Forget

The pre-production sample is the single most skipped-and-most-regretted stage. Buyers in a hurry say “skip the sample, just run it,” and then receive 10,000 bags with a color that is noticeably off. The sample exists to catch exactly that.

Paper bag sampling time / PPS lead time usually looks like this:

  • Production of the PPS: 5–10 business days on the real line.
  • Courier to you: 3–6 business days by express air (DHL/FedEx), longer if you choose cheaper mail.
  • Your review and decision: however long you take, which is the wild card.
  • Return shipping of changes (if needed): another 3–6 business days.

So a clean one-round sample costs you roughly 2–3 weeks of calendar time even when the factory is fast. That is not waste, it is insurance. A PPS lets you verify paper weight, print registration, handle attachment, and color before a single bulk sheet is cut.

Mini story: the brand that missed Black Friday. Lena ran a DTC apparel label and placed 8,000 bags with a new factory on October 2, 2025, for a Black Friday launch. The factory quoted “three weeks production.” What nobody budgeted was the PPS: the first sample arrived October 18 with a handle color two shades off-brand. A revision round ate another 12 days. Mass production finished November 14, and ocean transit landed the cartons on December 12, three weeks after the sale ended. The bags sold eventually, but the launch window was gone. The lesson was not “rush harder,” it was “add the sampling week to the plan from day one.”

If you want the mechanics of what a sample should contain and how to approve it, our write-up on the PPS (pre-production sample) walks through the checklist we send to factories. And the inspection that follows the bulk run is just as important, which is why we document quality control before shipping as a separate gate.

What Actually Slows You Down

FactorTypical added delayHow to avoid it
Artwork revision rounds1 weeks per roundSubmit print-ready files; confirm color mode and bleed
Late PPS approval1–2 weeksSet an internal deadline; pre-assign a decider
Custom die or handle3–7 days for toolingUse a stock size where possible
Material out of stock1 weeksConfirm raw stock before deposit
Chinese New Year / peaks2–5 weeksOrder 6–8 weeks ahead of the holiday
Customs or doc errors3–10 days at destinationUse a broker; pre-check HS codes
Revision after bulk startsFull re-run riskNever start bulk before PPS sign-off

Most delays are not the machines. They are decisions, documents, and dates. The table below ranks the usual suspects by how much time they add.

Two of these deserve emphasis. The Lunar New Year shutdown alone can add a month to any Asian order placed in December or January, with many factories closing two to three weeks with little notice. Separately, documents bite: a mislabeled HS code or a missing certificate of origin can hold a container at your port longer than the whole ocean voyage took. Neither is the factory’s fault, and both are yours to manage.

For the sustainability side of material sourcing, the FSC paper packaging business resource explains the certification chain that sometimes adds a paperwork step to lead time.

Rush vs. Standard: When Expediting Makes Sense

Sometimes the calendar wins and you need bags faster than the standard clock allows. Factories can compress production, but not for free and not infinitely.

Rush charges pay the factory to bump your job ahead of others and run extra shifts. They do not conjure raw material that is not in the warehouse, and they do not shorten ocean transit. A rush that still goes by sea may arrive only marginally sooner but cost far more. The bigger win is usually air freight on a modest order, not a factory super-rush on a container. If you are weighing that premium against your budget, our why printed bags cost more guide shows where the money actually goes.

One more caveat: compressing production time tends to compress QC time too. If you expedite, insist that the quality control before shipping step stays intact, because a fast delivery of wrong bags is worse than a slow delivery of right ones.

OptionProduction speedAdded costWhat you sacrifice
Standard4–6 weeks factoryBaselineNothing
Rush (overtime)2–3 weeks factory+15–30%Less scheduling flexibility
Super-rush (line jump)7-12 days factory+30–60%Higher defect risk, limited QC
Air freight instead of seaSaves 2–5 weeks transit5–10x shippingMargin, unless volume is small

Shipping Adds Its Own Clock

Shipping methods for packaging

The factory clock stops at the loading dock. Yours keeps running. For most overseas buyers, transit is the largest single block of the artwork to delivery timeline paper bags, and it is the easiest to misjudge.

Shipping modeTransit time (Asia to US/EU)Relative costBest for
Ocean LCL (shared container)30–45 days1x (baseline)Most orders, any volume
Ocean FCL (full container)25–38 days~0.7–0.9x per unitLarge orders 10k+
Air express (DHL/FedEx)3–5 days5–10xSmall, urgent, high-value
Air freight (consolidated)7–14 days3–5xMedium, time-sensitive
Rail (China–Europe)18–25 days~1.5–2xEurope only, middle ground

These windows are port-to-port. Add another 3–10 days for customs clearance, last-mile trucking, and any broker delay. The Freightos freight rate index is a useful public benchmark for current ocean and air trends, because transit reliability shifts with global demand.

A subtle point: air is not always faster end-to-end once you include pickup, consolidation, and clearance. For a 2,000-bag order, air freight can genuinely save three weeks versus sea. For a full container, the cost usually makes sea worth the wait.

Mini story: the buyer who caught a batch with the PPS. Marcus sourced packaging for a coffee roaster and ordered 15,000 bags in March 2026. He almost waived the sample to save ten days, but his broker talked him into a PPS. The sample arrived with a kraft tone shifted warmer than the brand’s approved swatch, a drift nobody would have noticed on a screen. Because he caught it at the PPS stage, the factory corrected the ink mix before bulk, and the full run shipped on the original date. The ten days “lost” to sampling prevented a 15,000-bag recoloring that would have cost weeks and a five-figure reprint. The sample paid for itself several times over.

For a step-by-step on the logistics half, see our guide to shipping paper bags from China, which covers FCL versus LCL and the documents brokers expect.

How to Reduce Paper Bag Lead Time

You cannot make a press run faster than physics allows, but you can remove almost every avoidable delay. These are the tactics buyers use to shave real weeks off the calendar.

Lock artwork before you request a quote

The fastest orders are the ones where the file is final on day one. Submit print-ready PDFs with correct bleed, CMYK color, and confirmed die lines. Every revision round after that costs you a week or more.

Approve the PPS on a deadline

Set an internal “sample decision day” before the sample even ships. Pre-assign one person to say yes or no. The single biggest variable in paper bag sampling time / PPS lead time is how long the sample sits on someone’s desk.

Overlap material prep with sampling

A good factory stages paper and handles while the PPS is in transit to you. Confirm they do this; if they wait for your sign-off before touching raw stock, you lose a week you could have banked.

Choose stock sizes and standard GSM

A custom die costs tooling days. A standard size and a common right GSM for your bags let the factory slot you into an existing cutting form. The bag still looks custom; the wait drops.

Pick the right shipping mode early

Decide sea versus air before you place the deposit, not after production finishes. If you will need air, tell the factory so carton dimensions suit air handling and you avoid a repack.

Consolidate with a reliable partner

Working repeatedly with one choose a reliable manufacturer means your specs, dies, and color swatches are already on file. Reorders can skip material sourcing and sometimes sampling entirely, cutting lead time by weeks.

Each of these is an administrative choice, not a miracle. The buyers who consistently hit dates are the ones who treat the timeline as a project plan with owners and deadlines, not as a number the factory “owes” them. When you are ready to map your own order, talk to a partner who plans in dates, not slogans and ask them to quote each stage separately.

Getting an Accurate Delivery Date from a Factory

A vague “three weeks” protects the factory and hurts you. Push for a date you can put in a calendar. The way to do that is to ask for a breakdown, not a slogan.

  • Ask for the ex-factory date separately from the arrival date. “When will it leave your dock?” and “When will it reach my warehouse?” are different questions with different owners.
  • Request the date tied to a milestone. “Production starts the day after PPS approval and deposit” is actionable; “soon” is not.
  • Confirm raw material availability up front. “Is the paper in stock today?” A yes now prevents a three-week surprise later.
  • Put the timeline in the contract. Include a latest ex-factory date and what happens if it slips. Written dates change behavior.
  • Build in a buffer you control. Plan as if the real date is 10–15% later than quoted. If it comes early, you win; if it slips, you are still safe.

This discipline matters more than the factory’s raw speed. A slower shop that hits its written date beats a fast shop that misses by a month. The printing methods compared guide also helps you ask the right technical questions, because a factory that answers specifics confidently is usually one that plans specifically.

Want a dated plan instead of a vague promise? Request a quote with your specs and we will return both an ex-factory date and an estimated arrival date you can put straight on the calendar.

A Real Buyer’s End-to-End Timeline

custom gift bags
Samples approved
Paper Bags auto glue machine
Mass production
custom paper bags packed poly bag and cartons from APP packing-method-of-custom-packaging
Packing & Inspection

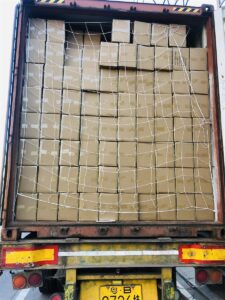

Full container1 (A)
Shipping

To make the abstract concrete, here is what a well-run 5,000-bag order looked like for a mid-size retailer in early 2026, planned from the start:

  • Day 0: Artwork finalized, deposit paid, PPS requested.
  • Day 2: Technical review cleared; sample into production.
  • Day 9: PPS shipped by express.
  • Day 14: Sample received, approved same day; bulk material already staged.
  • Day 15: Mass production began.
  • Day 28: Production complete, in-line QC passed.
  • Day 30: Cartons built, booked on ocean vessel.
  • Day 62: Arrived at destination port, cleared customs.
  • Day 67: Delivered to warehouse.

Total: about 9.5 weeks, with zero revisions and a PPS that overlapped material prep. Strip the PPS and they might have saved a week but risked a costly error. Compress nothing else without paying a rush premium. This is the realistic shape of a healthy paper bag manufacturer lead time, and it is the template you should build your own plan around.

What is the typical total lead time from artwork to delivery?

For an overseas order, plan on roughly 4–10 weeks door-to-door. That splits into about 1–3 weeks of sampling and production prep, 1–4 weeks of mass production depending on quantity, and 2–6 weeks of transit. Domestic or digital small-batch orders can land in 1–3 weeks. These are ranges, not promises, so request a dated quote.

Which stages of the timeline can be compressed?

Sampling can be sped up with express courier and a fast internal approval. Material prep can overlap the sampling window. Production can be rushed with overtime or line-jumping for a premium. What you cannot compress is ocean transit without switching to air, and you cannot skip the PPS without taking on defect risk. Most savings come from removing administrative delay, not machine time.

How long does sampling or a PPS take?

A pre-production sample typically takes 5–10 business days to produce, plus 3–6 business days of express shipping each way, plus your review time. Realistically budget 2–3 weeks for a clean one-round sample. A revision adds another 1–2 weeks. This is the step most first-time buyers forget to schedule.

How much does rush or expedited production cost?

Factory rush charges usually run +15–30% for overtime-level compression and +30–60% for super-rush line-jumping. Air freight instead of ocean can cost 5–10x the shipping line item. Rush also tends to shorten QC windows, so keep inspection intact even when paying for speed.

How do sea and air freight affect arrival time?

Ocean transit from Asia is roughly 25–45 days port-to-port; air express is 5–10 days and consolidated air freight 8–14 days. Add 3–10 days for clearance and last-mile. Air can save three weeks or more but at several times the cost, so it suits small, urgent, or high-value orders rather than full containers.

How do I get an accurate delivery date from a factory?

Ask for the ex-factory date and the arrival date as two separate numbers, tie the start to a milestone like “production begins after PPS approval and deposit,” confirm raw material is in stock, and put a latest date in the contract. Plan as if the real date is 10–15% later than quoted to absorb normal slippage.

Can I overlap sampling and bulk production to save time?

Partially. A good factory stages paper, ink, and handles while the PPS is in transit to you, which banks about a week. But the bulk run itself should not start until you approve the PPS, because a color or spec correction after bulk begins means a costly re-run. Overlap the prep, not the production.

Conclusion

Lead time is not a mystery and it is not a single number. It is a chain of six stages, and the total paper bag manufacturer lead time from artwork to delivery is whatever your slowest stage plus your shipping mode decides. The buyers who hit their dates are not the ones who found the fastest factory, they are the ones who planned the sampling week, locked artwork early, overlapped material prep, and picked a shipping mode that matched their deadline. Treat the timeline as a project with owners and milestones, keep the PPS and the quality control before shipping gate intact, and you turn an anxious guess into a calendar you can trust. When you are ready to map your own order, revisit our complete guide to custom printed paper bags for the specs that move both price and speed, and talk to a partner who will give you a dated plan instead of a slogan.
